Basement Remodel Timeline in Brownsburg, IN

Basement remodel phase schedule shown on a planning document in Brownsburg

Most Basement Remodels Follow a Predictable Phase-by-Phase Timeline

Planning a basement remodel in Brownsburg means wondering about the timeline. We get it. You need to know how long your home will be a construction zone. Every project follows a set of steps. The team calls these phases. They're predictable, which is nice. Your family can plan around them.

Here's how a typical basement remodel happens, step by step:

  1. Design and planning (2 to 4 weeks). This is where the big decisions happen. You pick your layout, materials, all the details. Many homeowners really underestimate this part. But a rushed plan causes real headaches later, it's better to take your time here. And for a Hendricks County building permit, the team gets that squared away.
  2. Demolition and prep (3 to 5 days). First, the old stuff comes out. Drywall goes, debris leaves. The team clears the space. They also look for any hidden moisture or weak spots. Around Brownsburg, in homes from the 90s or 2000s, we see outdated framing or little water leaks all the time. Those need fixing before we build anything new.
  3. Rough-in work (1 to 2 weeks). This is where the guts go in. New wiring runs. Plumbers put in drains and supply lines, if you're adding a bathroom or wet bar, for instance. HVAC lines get extended. This whole phase needs inspections. The walls can't close until that's done.
  4. Framing and insulation (1 to 2 weeks). Then the walls go up. Insulation follows. The basement finally starts taking shape. Rigid foam insulation is common for below-grade walls around central Indiana. It just handles moisture better. Fiberglass batts don't cut it the same way down there.
  5. Drywall, mudding, and paint (1 to 2 weeks). Drywall goes up. It gets taped, then finished. Paint comes next. This part needs patience. The mud needs to dry right, every single coat.
  6. Finish work (1 to 3 weeks). Now the fun stuff. Flooring goes down. Trim gets put on. Light fixtures, outlets, plumbing fixtures, everything gets connected. Cabinets and countertops go in too, if you're building a kitchenette or bar.
  7. Final inspection and walkthrough (2 to 3 days). Everything gets checked. The team walks you through the space. They handle any final touches you point out.

Add it all up, most projects take about 6 to 12 weeks. A quick bedroom and bathroom conversion will be faster. A full-on entertainment space, with a wet bar and custom built-ins? That's going to hit 12 weeks, maybe more. It really depends.

Here's a practical truth the team sees constantly in Brownsburg: homeowners think the build itself takes the longest. It doesn't. It's almost always waiting for materials or permit sign-offs. If you want a specific tile or a custom vanity, that can add weeks, two, maybe three. The team always tells clients to lock in material choices during design. Not after demo starts.

And here's a detail people often miss. Inspections aren't optional between phases. Hendricks County requires rough-in checks before drywall. If an inspector can't show for a few days, everything stops. This is normal, by the way. It just happens. It doesn't mean something broke.

The phases being predictable is good news. You can plan around them. You'll know when things get loud. You'll know when the crew needs your electrical panel access. You'll know when your new space is almost done. It helps manage expectations.

If you're mapping out a basement remodel timeline for your Brownsburg home, call the team for a walkthrough. They'll give you a real schedule. One based on what your basement truly needs.


Several Factors Can Shorten or Stretch Your Remodel Timeline

Two Brownsburg basement remodels can kick off on the same day. But they might finish weeks apart. The reason? A few things homeowners rarely think about until construction starts. We see it all the time.

Here are the biggest things the team sees affecting timelines:

  • Moisture and water issues. Brownsburg has a lot of clay soil. Water finds a way in. If your basement needs waterproofing, drainage fixes, or a foundation crack repair before we frame? That's two to four weeks right there. It's non-negotiable.
  • Permit turnaround. Hendricks County needs permits for electrical, plumbing, structural work. The review takes a week or more. Spring and summer usually mean a slower permit office. Everyone is busy then.
  • Changes mid-project. You start planning a family room. Then you decide on a wet bar, or a whole new bathroom. Every new item adds time. It's not a problem. Just know the schedule will shift.
  • Material lead times. Custom cabinets, special flooring, a specific tile, these can take four to eight weeks to show up. Materials from local stores? Much quicker. That part is pretty straightforward.
  • The condition of your existing space. What shape is your basement in now? An unfinished space, good ceiling height, no structural issues, that's the fastest start. Low ceilings, old ducts needing rerouting, outdated electrical panels? All these add time. You won't even be at the fun part yet.

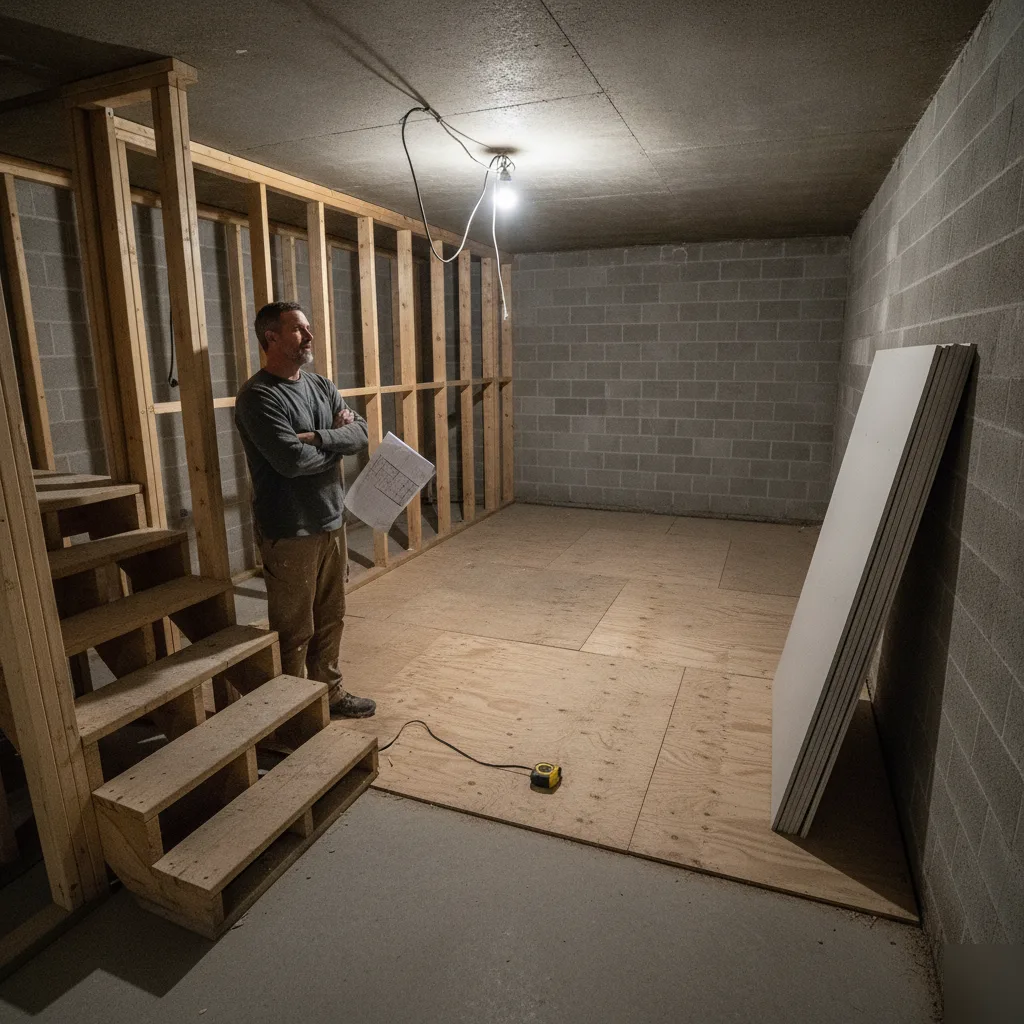

Basement remodel mid-construction showing framing and rough-in work in Brownsburg

Weather Plays a Bigger Role Than You'd Think

Most folks figure weather doesn't touch an indoor project. Not so. Heavy spring rains in central Indiana can show us water problems. Problems not visible during a dry inspection. The team has seen it in older Brownsburg homes near Arbuckle Acres. Moisture damage changes everything. It's good to find it early, but it still moves the schedule.

And you can't do concrete work or exterior waterproofing when the ground is frozen. Or soaking wet.

Decisions Made Before Day One Matter Most

Here's a practical truth most homeowners learn too late. The biggest delays on a basement remodel? They're rarely about the actual building. They come from choices not made before the crew even starts.

Picking your flooring, paint colors, fixtures, and layout before demolition begins can cut weeks off the job. If you wait to choose tile until after the plumber finishes the bathroom rough-in, everything stops. The plumber leaves for another job. Your project just sits there, idle for days. Or longer.

The team once worked with a Brownsburg homeowner who had every single material selected. It was all on-site before framing even started. That basement remodel moved from demo to final walkthrough incredibly fast. Preparation isn't glamorous. It just works.

So, if you want your basement remodel to keep moving, focus on planning. Lock in your design. Order materials right away. And ask your contractor exactly what decisions they need from you. And when they need them. The American Institute of Architects offers a helpful guide on planning your home renovation project that walks through the key decisions to make before work begins.

If you want help figuring out what your specific basement will need, call the team. We'll have a straightforward conversation about your Brownsburg project.


Permits and Inspections Add Real Time to Any Brownsburg Basement Project

Most homeowners don't think about permits. Not until the team brings them up. That's okay. But in Brownsburg, permits and inspections add real time to your basement remodel. Two to four weeks. Sometimes more. And you can't skip them if you want a job done right.

Hendricks County needs permits for most basement remodel work. Structural changes, electrical, plumbing, HVAC, all need them. Even just finishing a basement with new walls and lights usually needs a permit. The town of Brownsburg handles this through the Hendricks County Building Department. The team files the application. Then we wait for approval before any regulated work starts.

What Triggers a Permit

Not every single thing in a basement remodel needs a permit. Painting walls won't. Laying carpet won't. Swapping out furniture won't. But the moment you frame new walls, run electrical, or add a bathroom, you're in permit land. Here's what usually needs a permit in Brownsburg:

  • Framing new interior walls or moving existing ones
  • Adding or relocating electrical outlets, panels, or lighting circuits
  • Installing new plumbing lines for a bathroom or wet bar
  • Modifying ductwork or adding HVAC supply to the basement
  • Adding an egress window for a bedroom

Each of those trades might need its own permit. So a basement remodel with a new bathroom and bedroom? That could mean three or four permits filed at different times.

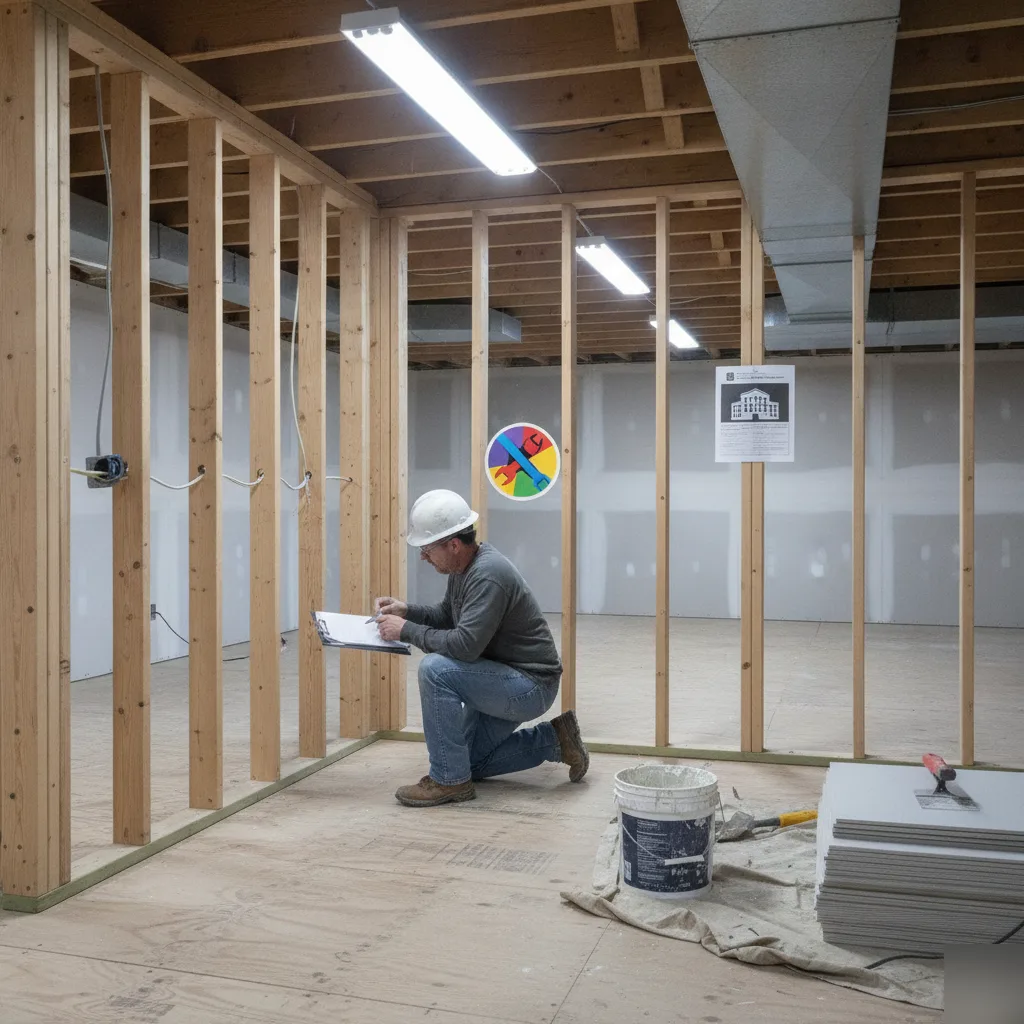

Basement remodel permit inspection of framing work in Brownsburg

How Inspections Slow Things Down

Here's what really catches people off guard. You don't just get a permit and work non-stop. Inspections happen at certain points. The rough-in check has to pass before drywall. The electrical inspection happens before outlets are covered. If an inspector finds a problem, work stops. Until it's fixed. And re-inspected.

The team has seen projects lose a whole week waiting for just one inspection. It really depends on how busy the county office is. In Brownsburg, during spring and summer, building activity booms. Inspection wait times get longer. Experienced contractors build these delays into the schedule from day one. That's just how it works.

A common scenario involves homeowners who had unpermitted work done years ago. It happens. When the team opens walls for a basement remodel, they find wiring or plumbing not up to code. That has to be fixed. The inspector won't sign off otherwise. It adds unexpected time, yes. But it's the only safe way forward.

Why This Step Protects Your Investment

Permits feel like red tape, but they protect you. A permitted and inspected basement remodel means the work follows Indiana Residential Code. Your home insurance covers the finished space. And you avoid problems when you sell your home later. That peace of mind is worth it.

Unpermitted work is a real headache. The team sees it all the time in Hendricks County real estate. Buyers' inspectors find it. Appraisers flag it. Title companies ask questions. That can easily delay, or kill, a sale. It's a messy situation.

So yes, permits add time to your basement remodel. But they add real value. The team handles all the filing, scheduling, and working with inspectors. You don't chase paperwork. You don't wonder what's next. If you're planning your project, our basement remodeling services page walks you through what to expect, start to finish.

Finished basement remodel completed in a Brownsburg, IN home

Frequently Asked Questions

How does Brownsburg's clay soil affect my basement remodel timeline?

Clay soil in Brownsburg can add two to four weeks to your remodel timeline. Clay holds water. That water pushes against your foundation walls. Before framing can start, the team has to check for moisture problems and fix them. If drainage work or waterproofing is needed, that happens first. Skipping it causes bigger problems later. Homes near areas like Arbuckle Acres are especially worth checking carefully before any walls go up.

What is the biggest misconception homeowners have about basement remodel timelines?

Most homeowners think the actual building takes the longest. It usually doesn't. The biggest delays come from waiting — waiting for permits, waiting for materials, or waiting on inspection sign-offs. A custom tile or special vanity can take four to eight weeks just to arrive. Decisions not made before demo starts are the real schedule killers. Locking in your material choices during the design phase is the single best thing you can do to keep your project on track.

Do Hendricks County building permits really slow down a basement remodel?

Yes, permits are a real part of your timeline in Brownsburg. Hendricks County requires permits for electrical, plumbing, and structural work. Review can take a week or more. Spring and summer are the slowest times because everyone is building. Inspectors must sign off between phases too — like after rough-in work and before drywall goes up. If an inspector can't come for a few days, the whole project pauses. This is normal. It doesn't mean anything went wrong.

What happens if I change my mind about the layout after construction starts?

Adding a wet bar or bathroom after demo has already started will stretch your timeline. Every new item means new planning, new materials, and sometimes new permits. It's not a disaster, but the schedule will shift. The best move is to make all your big decisions during the design phase — before a single wall comes down. That two-to-four-week planning window at the start of your project exists for exactly this reason. Use it fully.

How does the time of year affect a basement remodel in Brownsburg?

Indoor work can happen year-round, but the season still matters. Heavy spring rains in central Indiana can reveal moisture problems that weren't visible during a dry inspection. The team has seen this in older Brownsburg homes. Finding water damage is good, but it does move the schedule. Exterior waterproofing and concrete work also can't happen when the ground is frozen or soaking wet. If your project needs any outdoor foundation work, timing your start date matters more than you'd think.

Where can I learn more about what a basement remodel in Brownsburg actually involves?

The full picture goes beyond just the timeline. If you want to understand everything that goes into a basement remodel — from layout options to what the finished space can include — the basement remodeling services page covers it all. It's a good place to start if you're still figuring out what kind of space you want to build. Once you know what you want, getting a real schedule for your specific Brownsburg home becomes much easier.
